Choose another country or region to see content specific to your location.

That couldn’t be done, and they did it

That couldn’t be done, and they did it

The health and well-being of the communities of South Rajasthan are integral to the prosperity of Secure and Semsites. When the community needed oxygen supplies, it was natural that we would step up. This is the story of how we did it.

India was struck with fear, rising deaths, and national paralysis. Businesses were closed, factories were counting their sick, and anyone producing oxygen or oxygen-generating equipment was beleaguered as a crippled nation tried to confront the Covid second wave at the end of April 2021. We were also searching for ways we could help.

“Somebody said that it couldn’t be done” – E A Guest

This story began with a South Korean vendor enquiring about the well-being of our people. On the off-chance of finding a solution, our Group-CEO asked him if he had any leads on purchasing some PSA-based oxygen generators. Our Procurement team took up the mantle and enquired high and low for oxygen generators. Marshalling every form of communication at hand, the team found a credible supplier on 26th April itself, albeit late at night. Best of all, the supplier was based in the neighbouring state of Gujarat. Perhaps we thought this wouldn’t be so hard after all.

“That ‘maybe it couldn’t,’ but he would be one
who wouldn’t say so till he’d tried” – E A Guest

Gruelling discussions—technical, commercial, and logistical—ensued. Within a working day, it seemed we might be able to strike a deal for five machines made in India itself. Usually, a purchase of this scale and technical complexity would have required weeks of discussions, but we rallied together and completed it in a day. At the last moment, the supplier said he could only deliver in 48 days; his present stock had been diverted. As far as we were concerned, this was 40 days too many. It was back to the drawing board, and we had lost a whole day.

Given the urgency, we continued to work on leads from other vendors from across the globe. On 27th April, we found an Australian company through a local private hospital. Deep negotiations began immediately. We knew we had a small window of opportunity before the close of play in Australia (5:30 hours ahead). During these discussions, we found the Australian company was owned by a Chinese company, further complicating the conversation.

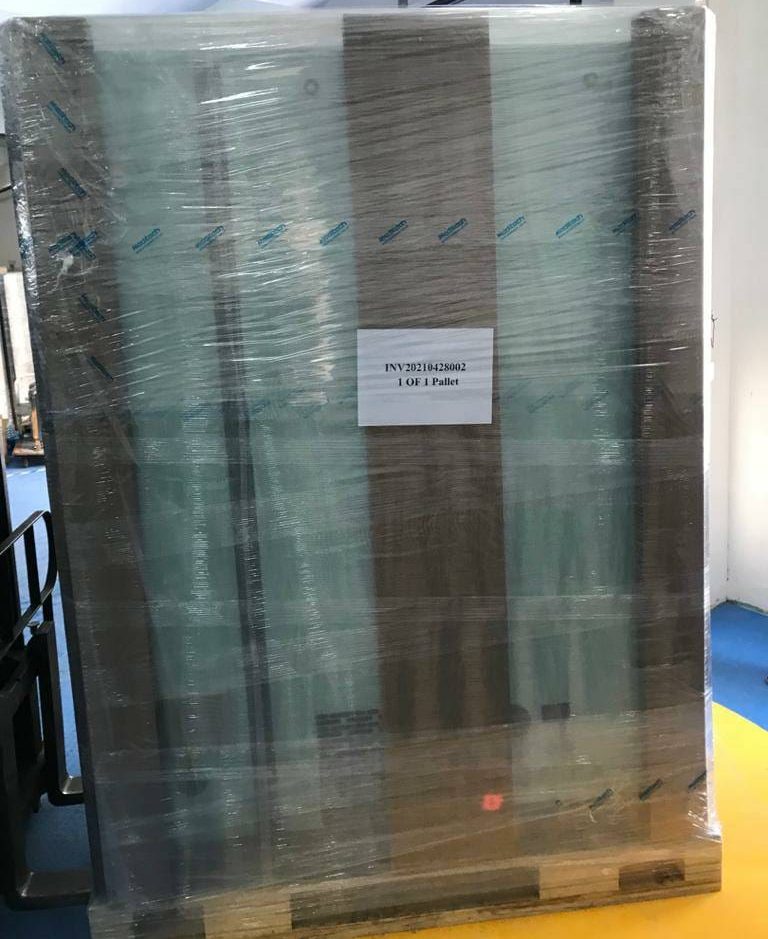

Miraculously, they had five machines in stock in Hong Kong. In all negotiations, there is a give and a take. As we were in a hurry for delivery and there was a clear supply-demand gap, we knew we could not push too hard on price or payment terms. By 28th April, within 24 hours, tens of millions of rupees worth of capital equipment had been ordered. Five plants were to be dispatched as per our schedule. We had to pay upfront before they shipped.

“There are thousands to tell you it cannot be done, there are thousands to prophesy failure” – E A Guest

On placing the order, the Logistics team in China came across a seemingly impossible hurdle—the Golden Week holiday from the 1st to 5th May. China comes to a standstill to celebrate this week. We had to take a leap of faith: trust a vendor we knew nothing about, trust the banking systems to ensure money paid from Udaipur, India, through the vendor’s branch in Bengaluru, would be routed through the Australian company to its Chinese parent so shipment could take place. We paid on 29th April; they promised to ship three machines on 1st May, but two machines would come later. A few early morning negotiations later, all five were promised for dispatch.

“But he took off his coat, and he took off his hat And the first thing we knew, he’d begun it” – E A Guest

Into the ring stepped former Semsite and a long-standing friend of Secure, Harpreet S Puri. He became ‘our man in China.’ Having no previous experience with the vendor and only phone calls and emails to work from, we needed assurances about the goods. Harpreet flew in, inspected them, and listened. Then, we hit the next obstacle. Due to Covid restrictions, the next freight flight to India was scheduled for after 7th May.

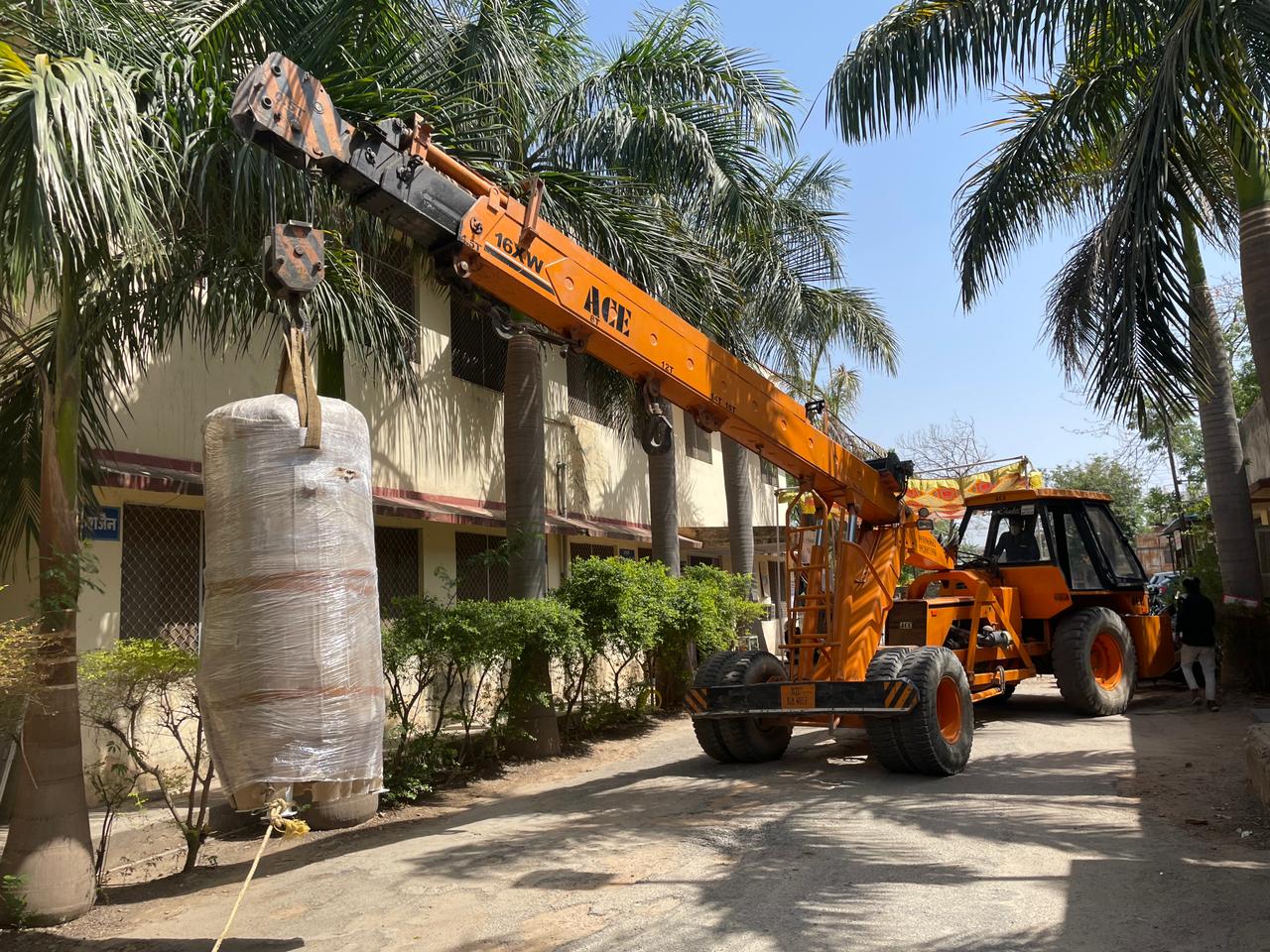

We didn’t lose hope. Our freight forwarder arranged a chartered flight on the 5th May, and the material was delivered in India on the 6th. We had already completed all the custom-related formalities in advance, and on 7th May, the machines were in Udaipur.

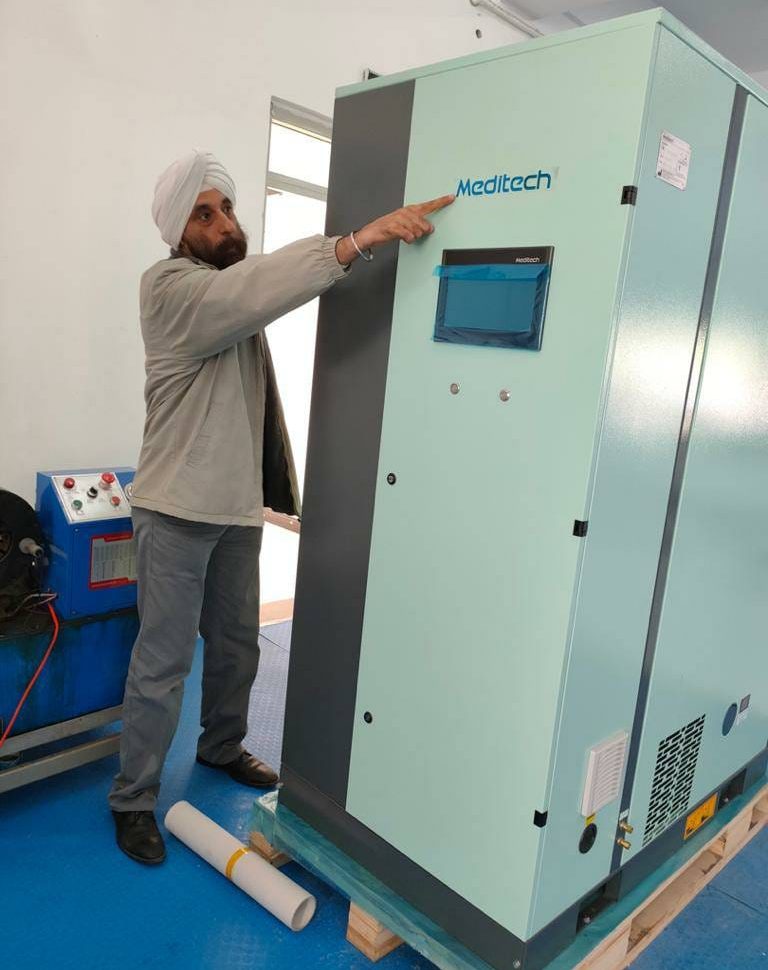

Harpreet S Puri

“So he buckled right in with the trace of a grin on his face. If he worried, he hid it.” – E A Guest

Oxygen generators don’t work in isolation; they need compressors, piping, tanks, air conditioning, and a myriad of other facilities to work. In parallel with procuring the machines, the Logistics team began sourcing all the parts. The team from the oxygen generator company in Bengaluru was incredibly helpful. We could get everything. The storage tanks needed to be welded in Coimbatore, but all the oxygen required for welding had been reserved for medical use. No oxygen, no welding. Through local sources and help from the government, even this hurdle was crossed.

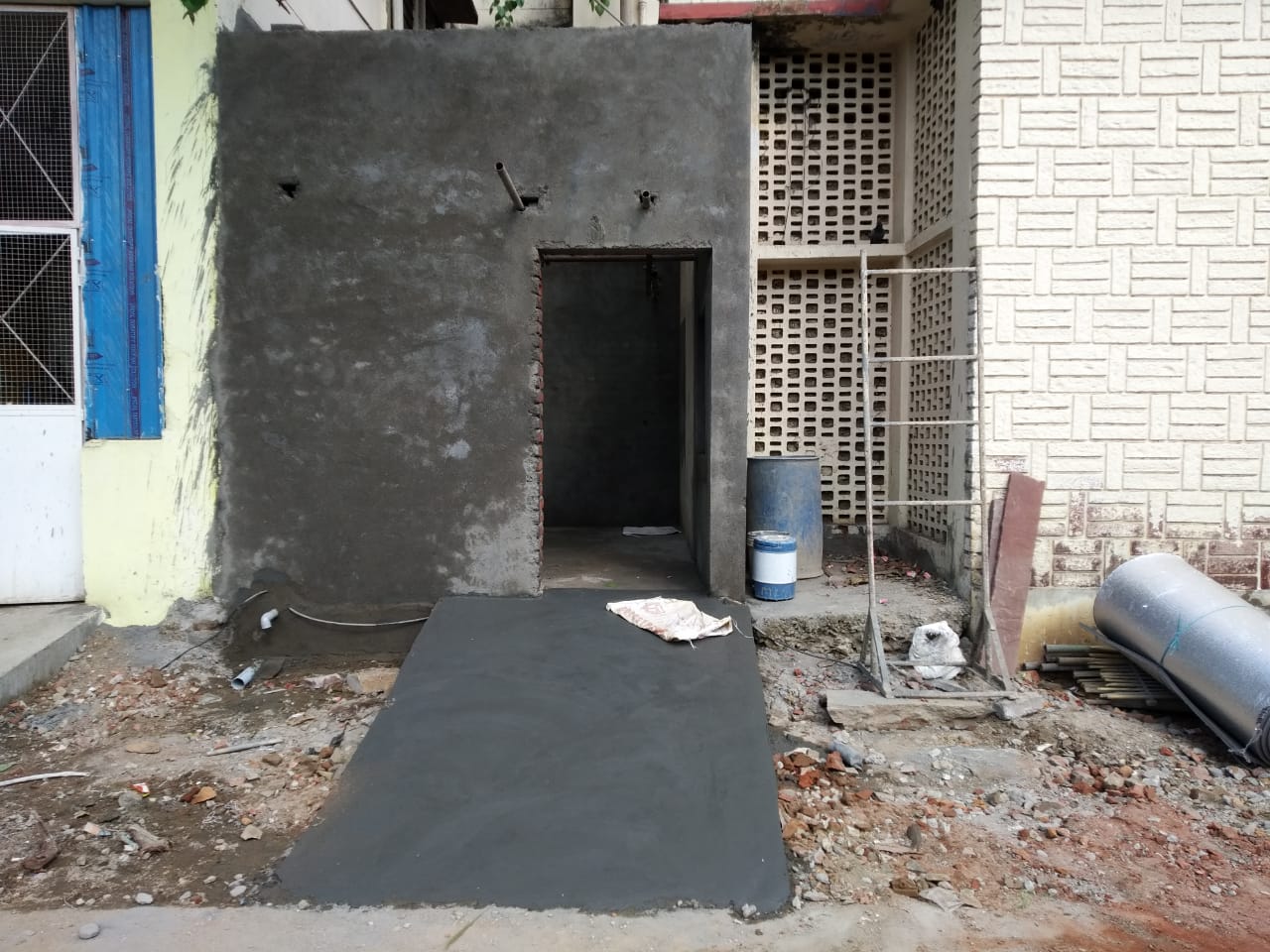

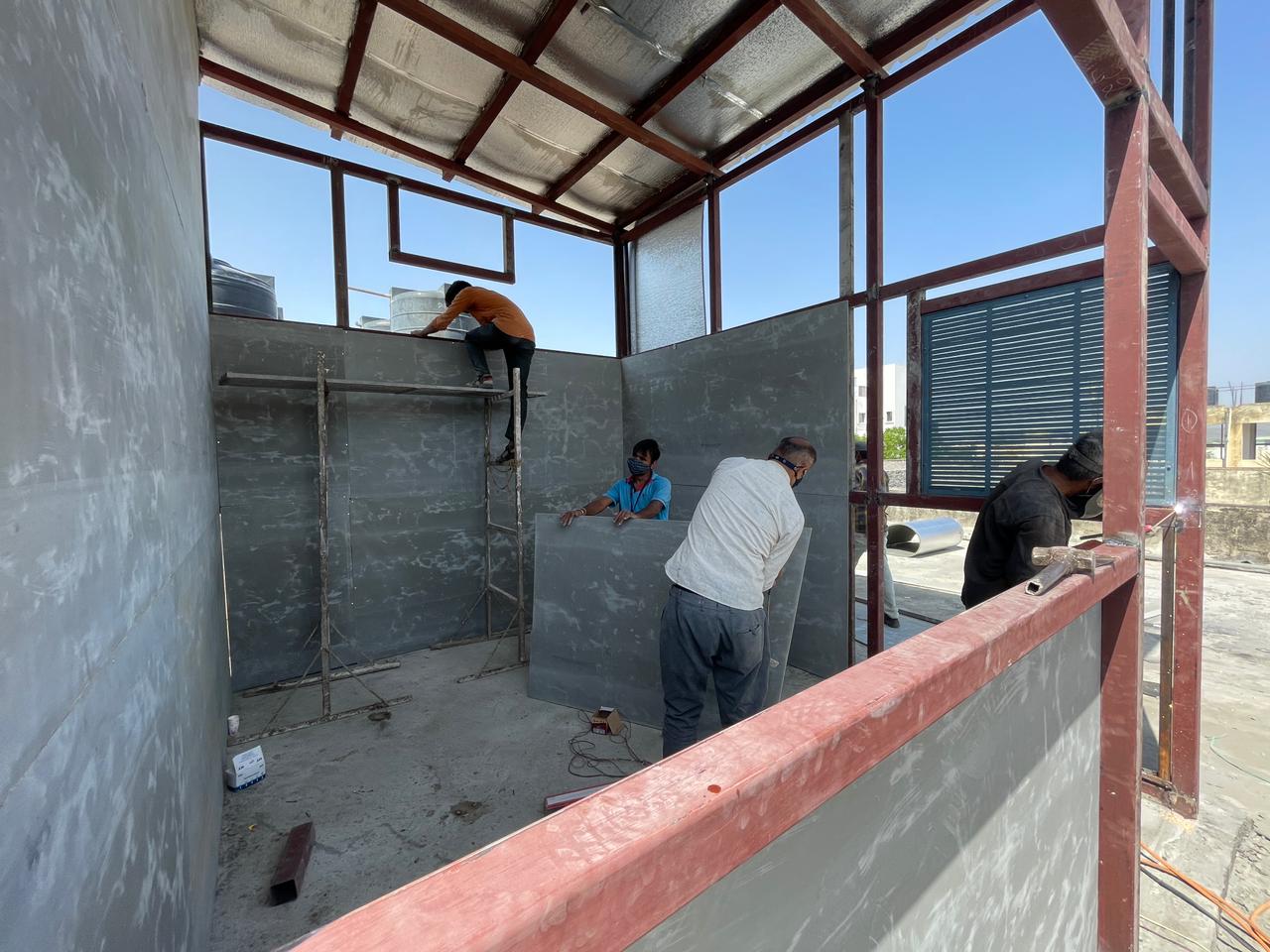

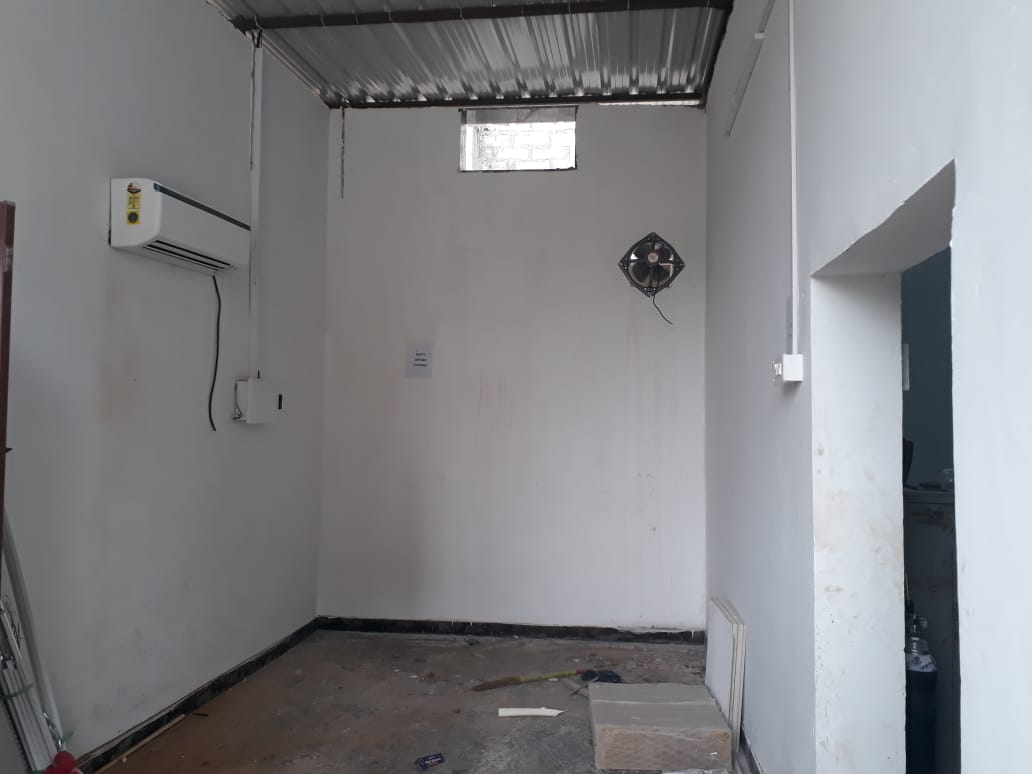

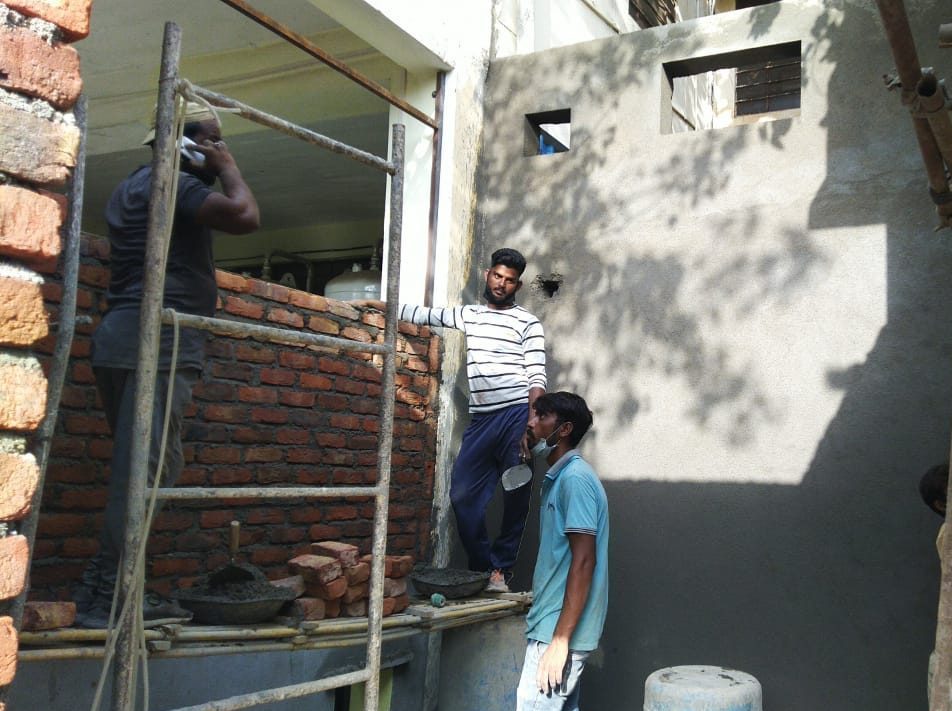

None of the hospitals we were donating to had existing facilities to house an oxygen generator. We needed to build these, with foundations and footings, walls and windows, pipes and power. Work started at five different sites on 1st May. Once again, Covid restrictions reduced our ability to bring suppliers, contractors, and specialists to the sites. Thankfully, the local administration helped and enabled shops, workshops, and contractors to open up. We built four complete buildings in three cities in 14 days; one hospital was able to give us some internal space. We built three independent buildings and one service room on the roof. As the hospital was an active Covid centre, we had to crane all the materials and people in from outside. We also had to prepare cabling, ducting, and copper piping. That presented the next challenge.

“With a lift of his chin and a bit of a grin, Without any doubting or quiddit” – E A Guest

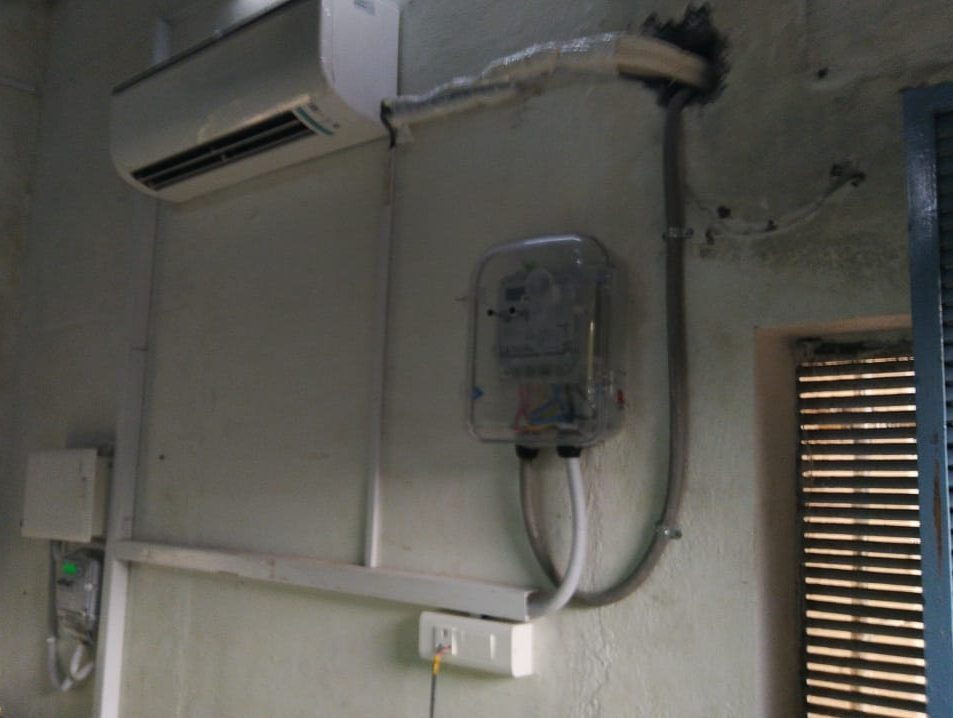

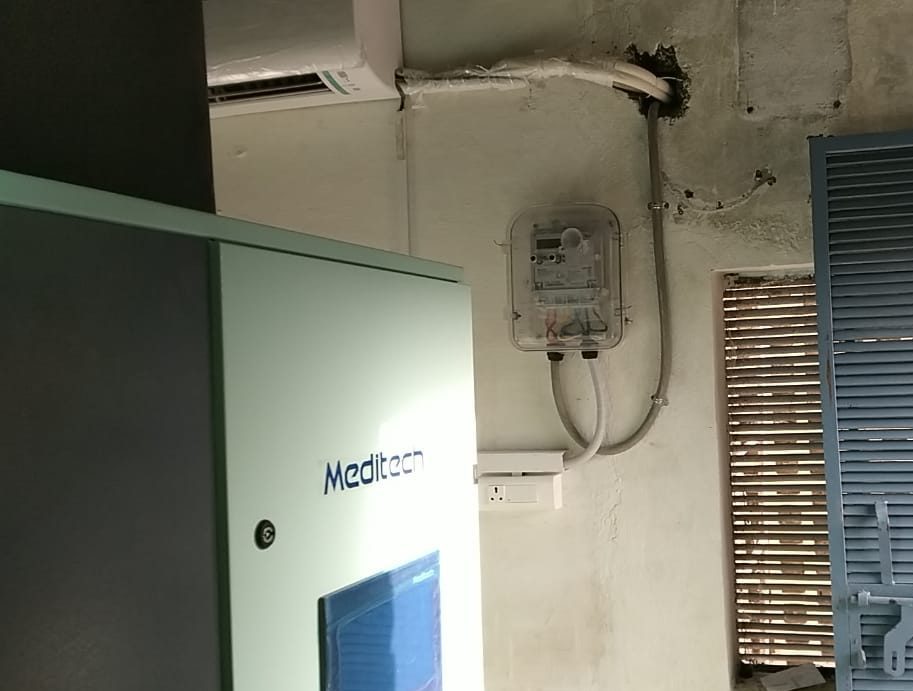

Medical-grade copper pipes and approved fitters were both in extremely short supply. With assistance from Hindustan Zinc, local administration, and air conditioning service providers, we cobbled together a team of people who worked within the hospitals alongside our teams. This activity became our critical path, with components being flown in to meet our needs.

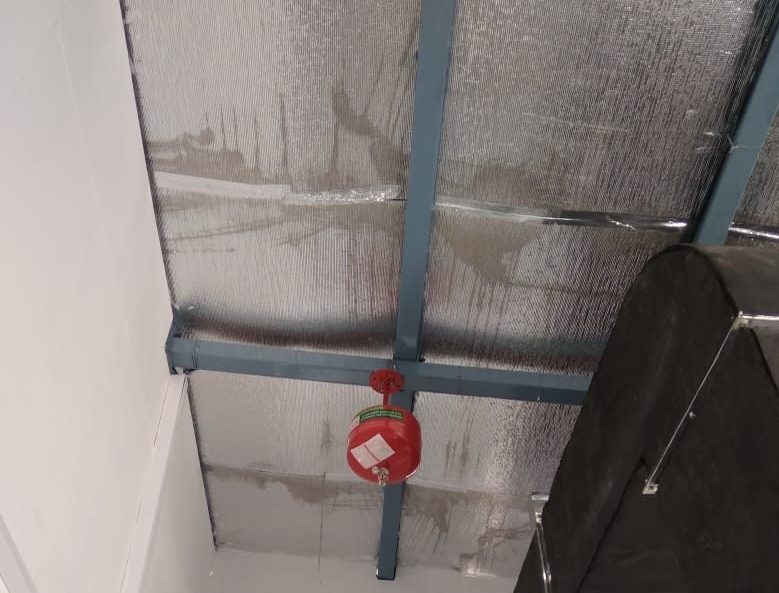

At each site, we came across construction challenges. At Ambamata Hospital, we found that the flooring was inadequate to bear the weight of the columns, and new flooring would require a 4-5 day curing period. Thankfully, our ‘Third Space’s’ contractor stepped in, and the flooring was done in a day. In Bhilwara, insulation fell short. We immediately sourced it from another active site in Udaipur. In Banswara, we couldn’t even find a contractor willing to work in pandemic conditions at the hospital.

Teamwork, innovation, communication, and a can-do, must-do attitude reigned over the team and the myriads of people who supported us. We were all connected by a common purpose and high technology—calls, virtual meetings, group chats, video calls, etc. People came together from Australia, Hong Kong, Shanghai, Delhi, Gurugram, Bengaluru, Coimbatore, Ahmedabad, Bhilwara, Banswara, Rajsamand, Jaipur, and Udaipur. Some were Semsites; others were not.

Together, we delivered.

“Just start in to sing as you tackle the thing That “cannot be done,” and you’ll do it” – E A Guest

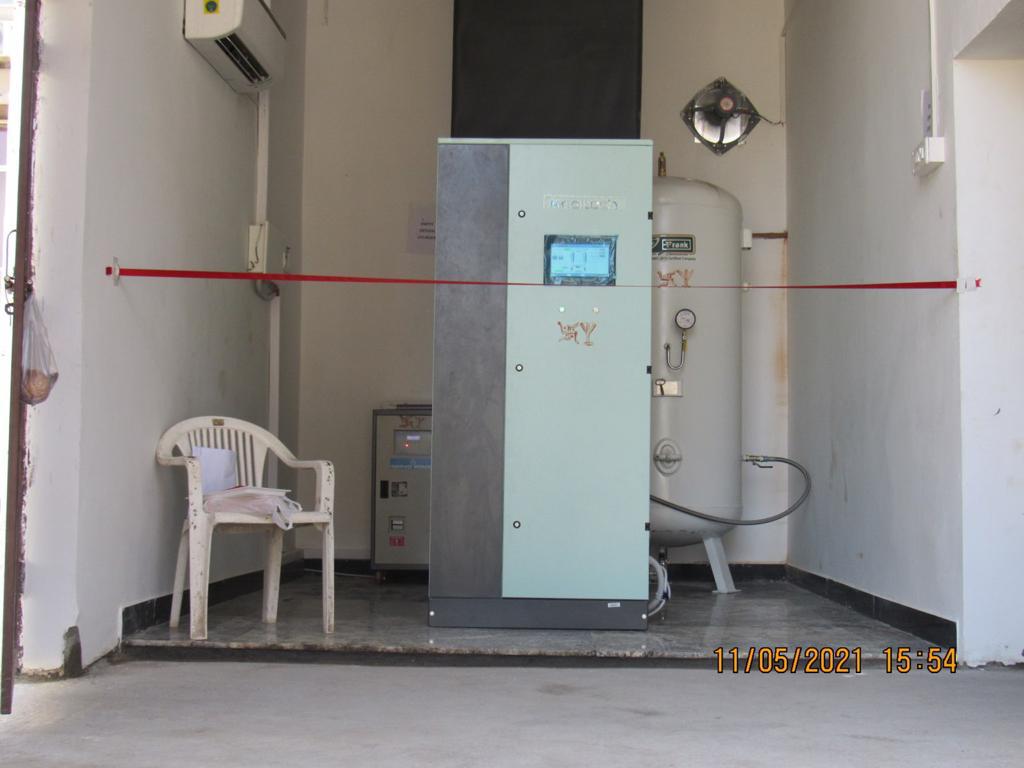

11th May 2021 – First plant operational at Ananta Hospital in Rajsamand

12th May 2021 – Second plant operational at Ambamata Satellite Hospital in Udaipur

14th May 2021 – Third plant operational at M G Hospital in Bhilwara

15th May 2021 – Fourth plant operational at M G Hospital in Banswara

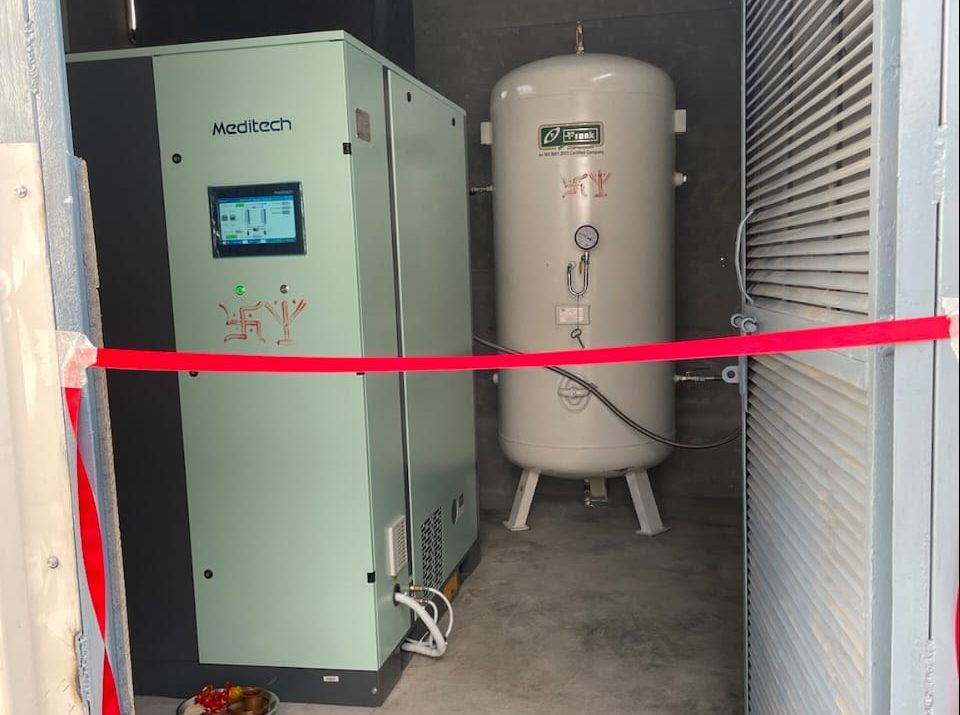

19th May 2021 – Fifth plant operational at Hiran Magri Satellite Hospital in Udaipur

Together, we can; together, we did!
